Know if solar pays at your site before a vendor says it does

MEP compares load fit, available space, interconnection conditions, operating risk, commercial structure, and capital returns before equipment vendors enter the process.

Start with one site or a complete facility list. NDA available before data is shared.

Conditions that affect the portfolio decision

MEP first reviews the facts that could change scope, value, timing, or operating risk.

Portfolio potential is uneven

The best roof area may sit at the wrong load, tariff, interconnection point, lease term, or expansion plan.

Evidence to connectDaytime load, site control, usable area, circuit conditions

A vendor yield model is not an investment case

Losses, degradation, curtailment, exports, demand effects, downtime, taxes, financing, and contract terms must remain visible.

Evidence to connectHourly model, assumptions, capex or PPA terms, downside case

Interconnection belongs in the first screen

Circuit hosting information, protection, metering, application requirements, and schedule can affect feasibility before final design.

Evidence to connectPoint of connection, circuit, voltage, application path

Compare sites on a consistent basis

The comparison method stays consistent, while the technical scope reflects the conditions at each facility.

Portfolio screen

Rank sites by load match, tariff value, space, site control, interconnection evidence, and business timing.

First lookBills, interval load, roofs or land, lease and expansion status

Technical feasibility

Test layout, yield, structural and electrical constraints, generation profile, protection, and maintenance access.

First lookPlans, single-line diagrams, structural information, site survey

Commercial structure

Compare ownership, financing, lease, or onsite PPA options on the same cash flow and risk basis.

First lookCapital criteria, tax position, proposals, contract terms

Procurement and oversight

Issue a common scope, normalize bids, review design, and verify construction and commissioning against acceptance points.

First lookDesign basis, warranties, schedule, performance tests

What each decision owner must approve

The analysis addresses the technical, operating, financial, and commercial questions assigned to each function.

Decision ownerQuestion to answerMEP output
Plant engineering

Can the system connect without disrupting production or future expansion?

Electrical, structural, protection, and phasing criteria

Finance

Which ownership structure produces acceptable risk-adjusted value?

Cash flow, sensitivity, tax, degradation, and downside case

Procurement and legal

Are proposals comparable and contract obligations visible?

Normalized scope, exceptions, guarantees, and remedies

Corporate sustainability

What contribution can be counted and reported credibly?

Generation basis, boundaries, attributes, and reporting method

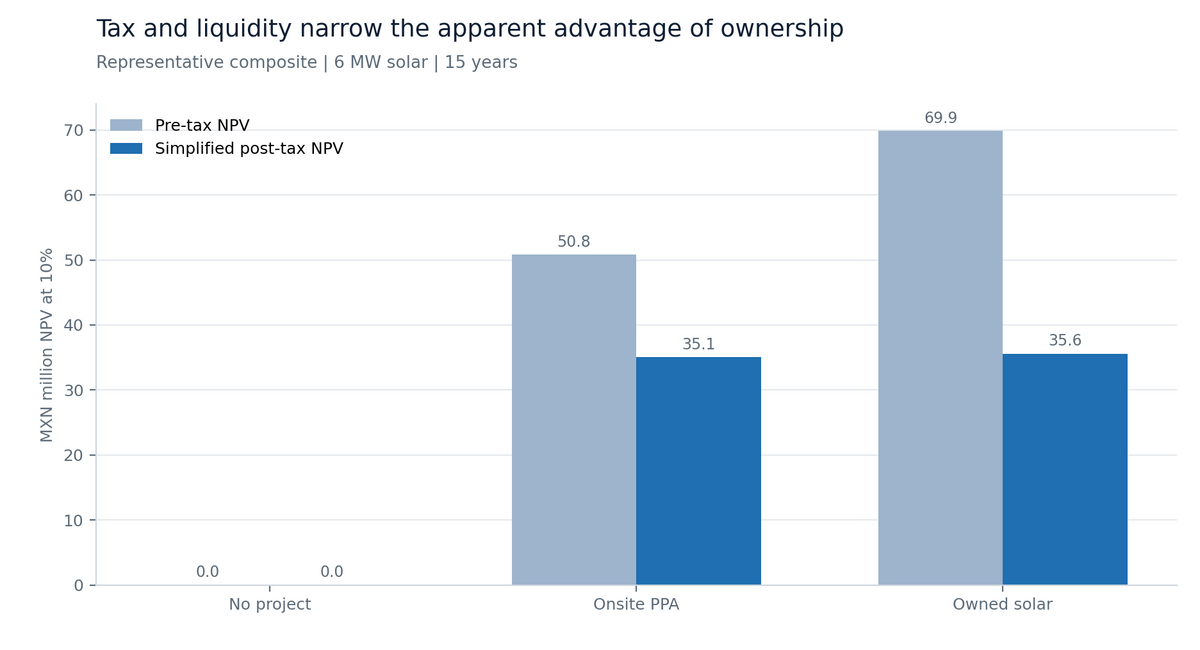

Chart from the handbook: pre-tax and simplified post-tax NPV at 10% for no project, an onsite PPA, and owned solar, 6 MW over 15 years. Pre-tax, owned solar shows MXN 69.9 million against 50.8 million for the PPA; post-tax the two are 35.6 million and 35.1 million.
From Buying Power in Mexico. Representative composite, 6 MW solar, 15 years, MXN million NPV at 10%.

From the handbook

Tax and liquidity narrow the apparent advantage of ownership

Pre-tax, owning the array looks decisively better than buying its output under an onsite PPA: MXN 69.9 million against 50.8 million in the composite case. After a simplified tax treatment the two land within half a million of each other, 35.6 million against 35.1 million, before any value is placed on keeping the capital liquid.

The lesson for the plant is that the ownership decision is a finance decision as much as an engineering one, and the vendor’s pre-tax comparison will not settle it. MEP runs both cases against your own tax position, cost of capital, and balance sheet before a structure is recommended.
